Electrical Labor Units: 3 Worked Examples Estimators Can Copy

September 21, 2026
Electrical Labor Units: 3 Worked Examples Estimators Can Copy

A labor unit is a standardized man-hour value assigned to an electrical task, and the fastest path to an accurate bid is simple: pull the unit from the NECA Manual of Labor Units (MLU)), multiply it by your quantity, apply a job-condition modifier, then multiply the adjusted hours by your loaded labor rate. Everything below shows you the math, the modifiers, and the mistakes that quietly wreck margins.


TL;DR:

  • Labor units in NECA's Manual are the industry standard for converting material counts into man-hours, with site condition modifiers impacting the base figures.
  • Estimators should always apply the correct difficulty modifier at the item or job level and track these adjustments across multiple jobs for more accurate future estimates.
  • Foreman and supervision hours are not included in NECA units and must be estimated separately based on project complexity.
  • Overestimating productivity or ignoring non-productive time can lead to bid errors, making careful validation of assumptions essential.
  • Using dedicated estimating software that automates quantities, modifiers, and job costing reduces errors and streamlines the estimation process.

Subascent
Build Electrical Bids With Less Rework
Subascent helps electrical estimators organize quantities, labor units, and job costing in a workflow built for specialty trade businesses.
See how Subascent works

Table of Contents

What Labor Units Are and Why Estimators Rely on Them

A labor unit converts a material count into a man-hour figure. Instead of guessing how long 40 duplex receptacles will take, you look up the unit value, multiply by 40, and get a defensible hour count you can price and defend to a general contractor.

The NECA Manual of Labor Units is the industry baseline most electrical estimators build from. It has been refined over decades of field data and gets updated periodically, most recently with new units for EV charging stations and other items that didn't exist in older printings, according to NECA's own announcement.

Two other resources round out most estimators' toolkits:

  • Durand Labor Units Manual — an alternate unit set built from historical job-cost records, useful for cross-checking NECA figures or filling gaps where NECA doesn't list a specific item.
  • Mike Holt estimating guidance — practical training materials that walk through applying labor units and building a bid step by step, popular with estimators who learned the trade hands-on rather than in a classroom.

Labor units are also where your bid build order starts. You price labor first, then materials, then indirects and markup, according to PILARS' breakdown of electrical cost estimating. Get the labor number wrong at the front, and every downstream calculation inherits the error.

Inside the NECA System: Normal, Difficult, and Very Difficult

NECA doesn't give you one number per item. It gives you three, organized into Normal, Difficult, and Very Difficult columns, so you can match the unit to the actual site conditions instead of forcing every job through the same average.

Normal covers open, accessible work with good access and no obstructions, typically new construction or unoccupied space. Difficult applies when you're working around existing structures, partial occupancy, or moderate access constraints. Very Difficult is for the jobs everyone dreads: tight mechanical rooms, active hospital wings, or anything requiring after-hours access with limited working room.

By the numbers: Occupied renovation work commonly pushes NECA units up by a factor of 1.25 to 1.50, and confined-space work adds roughly 1.30x on top of the base unit.

One detail trips up newer estimators constantly: NECA's installation units exclude supervision labor entirely. Foreman and superintendent hours get estimated as a separate line, sized to the complexity of the job, never folded into the per-item unit.

Converting Units to Hours and Cost: The Formula and Three Worked Examples

The math has two steps, and both are simple once you commit to doing them every time instead of eyeballing a number.

  1. Total labor hours = the sum of (quantity × labor unit) for every line item on the job.
  2. Labor cost = total labor hours × loaded hourly rate, where the loaded rate is base wage plus burden (payroll taxes, workers' comp, benefits, and insurance). Burden typically adds 30% to 45% on top of straight wages, depending on your state and benefits package.

Here's how that plays out on three common items, using NECA's published labor units:

Add the hours across all three line items (37.0 hours) and you get a combined labor cost of $2,405 before any job-condition modifier gets applied. That modifier comes next, and it's where a lot of estimators either protect their margin or quietly give it away.

Adjustment Factors: When and How to Change the Base Units

NECA units assume typical conditions. Real jobs rarely stay typical for the whole scope, so you adjust.

  • Accessible new construction: 0.90 to 1.15x, since open ceilings and clear access can actually make production faster than the baseline.
  • Healthcare or occupied commercial: 1.20 to 1.45x for infection control protocols, patient traffic, and after-hours restrictions, per PILARS' estimating guidance.
  • High ceilings above 15 feet: 1.15 to 1.35x to account for lift time and rigging.
  • Night work or reduced crew windows: varies by shift differential and access restrictions, but rarely comes in under 1.15x.

Apply the modifier at the line-item level when only part of the scope is affected, such as one mechanical room with tight access inside an otherwise open building. Apply it at the whole-job level when the entire scope shares the same constraint, like a hospital wing renovation. Whichever you choose, write it down. A one-line note in your estimate describing the applied multiplier and conditions saves you an argument three months later when the job runs long and someone asks why.

Pro Tip: Keep a running log of which modifiers you actually used on completed jobs versus what the job cost report shows afterward. After ten or fifteen jobs, you'll have your own calibrated multiplier table that beats any published range.

What Estimators Get Wrong (and How to Fix It)

Every experienced estimator has a story about a bid that looked fine on paper and lost money in the field. Almost all of those stories trace back to the same handful of mistakes.

  1. Folding supervision into installation hours. NECA units don't include foreman or PM time. Estimate supervision as its own line, scaled to job complexity, not as a percentage buried inside your unit hours.

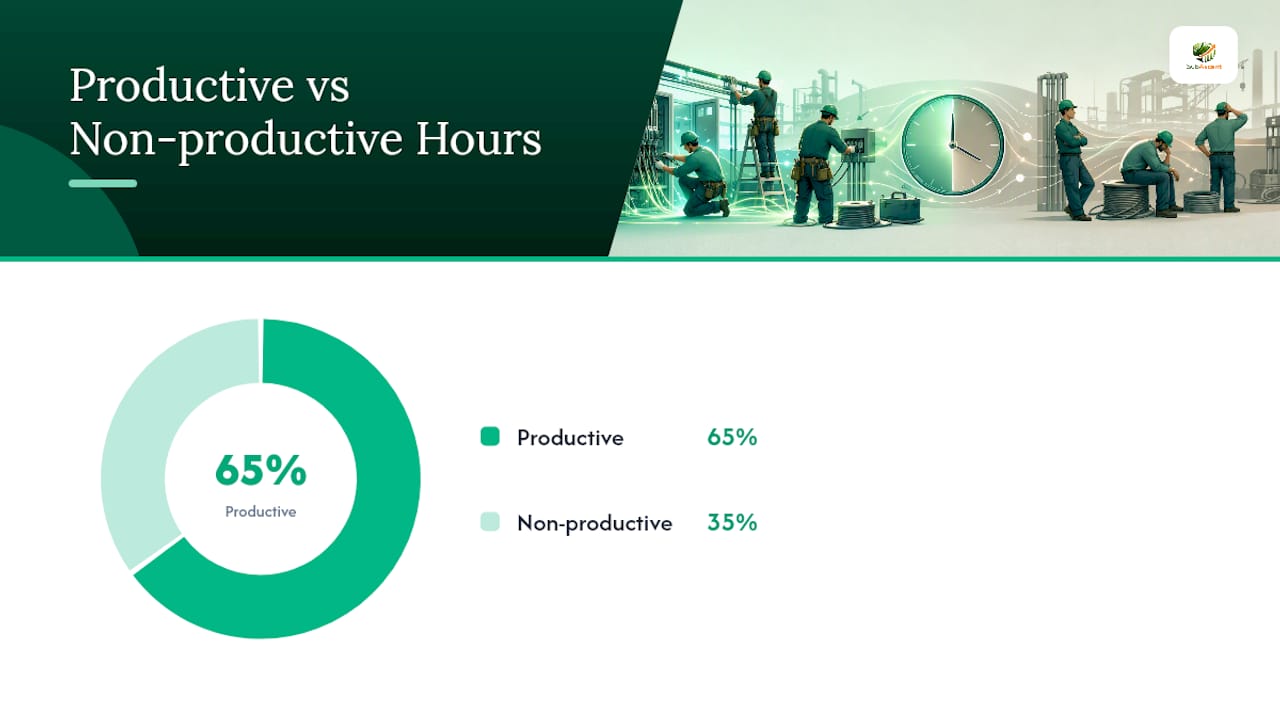

  2. Ignoring non-productive time. A useful sanity check: expect roughly 65% of labor hours to be productive installation work and 35% to be non-productive time spent on material handling, layout, and reading drawings. If your total hours assume 90% productivity, you've underbid the job before it starts.
  3. Mismatched crew mix. Pricing a job with two journeymen when the actual crew will be one journeyman and an apprentice changes both your hours and your blended rate.
  4. Poor parts stocking. Crews that stop mid-task to chase missing material lose more time than any modifier accounts for, and it shows up in your first-time fix rate and utilization numbers.

Pro Tip: Before you submit any bid over $50,000, run a five-minute QA pass: check supervision is separate, confirm your productivity split, verify crew mix matches the labor rate you used, and read the takeoff quantities one more time against the plan set.

For more on how these mistakes show up in job costing specifically, see this breakdown of electrical contractor job costing mistakes.

What Estimators Get Wrong (and How to Fix It) — overview diagram

Building Labor Units Into a Repeatable Estimating Workflow

A spreadsheet full of unit values only helps you if the process around it is consistent. The order of operations stays the same every time: takeoff quantities, apply labor units, adjust for conditions, add materials, then layer in indirects and markup.

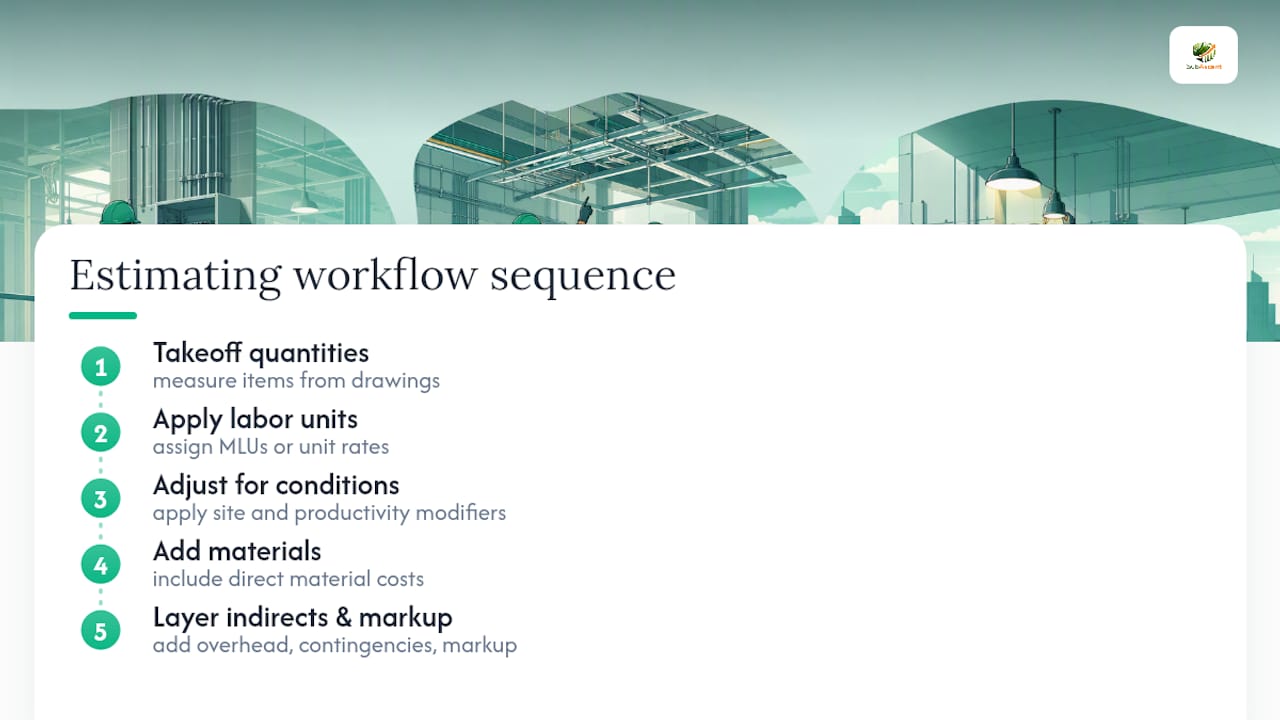

Five-step electrical estimating workflow

Version control matters more than most shops treat it. When NECA releases an updated MLU edition, or when your state adopts a new code cycle that changes install methods (worth tracking through resources like UFDoor's coverage of 2026 building code updates), someone on your team needs to update the master unit book and note the change date.

Unit pricing works well for fast budgets and change orders. Full labor-hour builds with modifiers are safer for fixed-price bids where a few percentage points of error changes whether the job makes money. Related reading on how productivity factors shift required hours across trades: labor productivity factors for trade subs.

A Perspective From Someone Who's Built Bids Under Pressure

Estimating textbooks make labor units sound clean. Field reality isn't. The value of a good unit book isn't the number itself. It's having enough documented adjustment history that you stop relying on gut feel when a job doesn't fit the Normal column.

[Dave's professional credentials and estimating experience summary to be inserted here]

— Dave

Get Your Labor Units Out of the Spreadsheet and Into a Real Workflow

Some estimating software is built for specialty trade subcontractors, focusing on their actual estimating workflows rather than general contractor perspectives. Instead of retyping NECA labor units into a new spreadsheet tab every time you bid a job, you build your unit book once, apply it consistently across estimates, and let takeoff quantities flow straight into labor-hour calculations.

Subascent

The PDF takeoff tools pull counts and linear footage directly off plan sets, so your quantities feed straight into whatever unit values you've set up, with condition modifiers applied automatically instead of hunted down manually on every line. Job costs sync to QuickBooks as the work progresses, so you see budget versus actual before the job closes, not three weeks after. If you're still tracking labor units in a spreadsheet that breaks every time someone adds a row, visit the Subascent product page to start a trial and see how it fits your next bid.

Sources

FAQ

What Are Labor Units in Electrical Estimating?

A labor unit is a standardized man-hour value assigned to a specific electrical task, like installing a duplex receptacle or pulling conduit. Estimators multiply the unit by the quantity on the job to calculate total labor hours, using resources like the NECA Manual of Labor Units as the baseline reference.

What Do Electricians Charge Per Hour for Labor?

Hourly labor rates vary widely by region, union status, and project type, and there's no single national figure that applies everywhere.

What Are the Six Components of a Labor Unit?

Labor unit figures generally account for factors like access conditions, working height, crew size, material handling, layout time, and installation complexity, though NECA's published units bundle these into a single Normal, Difficult, or Very Difficult value rather than breaking each one out separately. The exact components an estimator tracks can vary by shop and by how detailed their internal cost history is.

What Are NECA Labor Units?

NECA labor units are standardized man-hour values published in the NECA Manual of Labor Units, organized into Normal, Difficult, and Very Difficult columns based on site conditions. They serve as the industry's most widely used baseline for converting material takeoffs into labor-hour estimates, and tools like Subascent can help apply them consistently across every bid.
